  • Epworth Hospital Extension Project | Primavera Schedule Compression Techniques

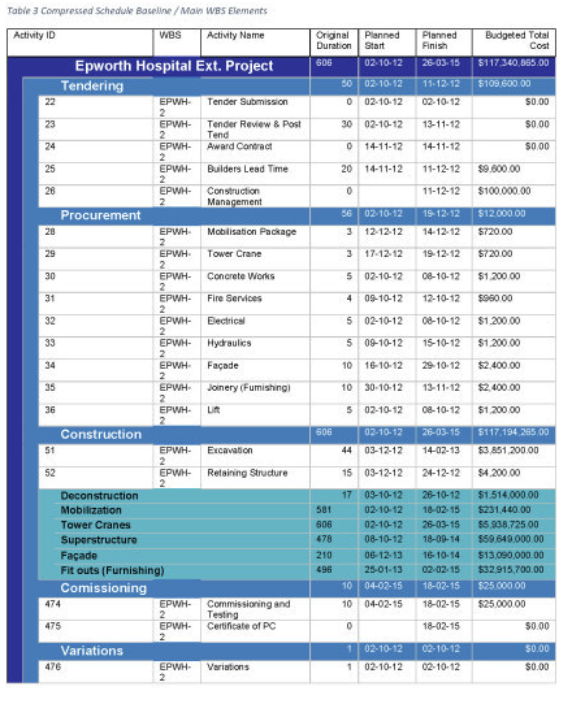

    We have been given the baseline below that represents the tender submission, for the following project. But according to the scenario (term-assignment for one of the subjects @my master’s degree in unimelb) during the post-tender negotiations, the client requested a schedule compression of 20% to meet their business goals.

    After acknowledging the request, schedule compression techniques are investigated to come up with the most beneficial “to-do plan”. Then I fast-tracked some activities as reasonably as possible so that the activity crashing process was implemented on the critical activities.

    Because of the nature of the schedule, it was essential to check the critical path after every crashed activity to see if it relocates itself on the timeline or not. Thus we had to implement an iterative approach. After every iteration of ACR reports, a summary level 4 WBS schedule of the critical path is printed to monitor the process.

    It took six iterations to compress the schedule by 20%. With this dynamic strategy, each ACR report listed all critical activities, based on the expert estimation of additional cost implications, and time savings, via sorting them by their cost slope values. Without such a tool, it would be impossible to engage at this level of precision.

    In conclusion, one of the most punchy features of the Primavera software is custom reports. It would be wise to utilise this function to do repetitive tasks and reports, especially to represent projects on a weekly basis. Fastens workflow, creates a baseline communication, fact based, removes human error. I precisely value the last advantage of it. I imagine myself asking for reports from a project scheduler on a weekly basis, it can easily turn into a life draining tragedy every Friday. People are trying to generate such reports by using complex work flows using different softwares, such as MSP, excel, p6, and other third party softwares in combinations. This renders the process weak against any human error, one might easily skip adding a column before exporting to excel, or can come up with a misleading excel graph. Whereas if you have an automated approach to weekly reports, you would remove all unnecessary risks and become far more efficient than any hardworking bee.

    by

  • Revit Server for Home

    Hello everyone! It’s been some time since I last updated you, as I’ve dedicated the past year to my personal growth. This period allowed me to delve into my readings and confront various software challenges to enhance my skills.

    Around six to seven months ago, I upgraded to a new laptop and repurposed my old one as a makeshift desktop. However, I soon realized my workaround was just to avoid the hassle of connecting and disconnecting my new laptop from my monitor. This prompted me to take action and set up my own server.

    Being an architect with a passion for software, particularly Revit, setting up my own server was something I should have considered much earlier. In past projects, we relied on central Revit files and BIM models. Yet, in Russia, a dedicated Revit Server was never established, and we resorted to a local area network with a file server for storing the central files. Although we faced no significant issues, I was aware that this setup was far from optimal. My attempts to transition to a proper Revit server were unfortunately dismissed based on my manager and the IT department’s advice. They believed that since everything was running on a local network within a single office without issues, there was no need to change.

    For those interested in setting up your own Revit server at home and feeling connected to a team, you’re in the right spot. Here’s how I went about it:

    First, I downloaded Windows Server 2012 for my 64-bit processor-powered laptop. Next, I set my network IPs, gateways, DNS, and subnets considering the router, access point, and unmanaged switch that I use for intranet. This stage took a while to understand, and I even wasted a week on networking 101 tutorials on YouTube. Luckily, a friend, Andrew, helped me out by reminding me to arrange my devices to be in the same subnet, which is one of the most important things to do. Otherwise, you’ll keep encountering Windows authentication asking passwords from Digest. If you get that error and can’t solve it using online guides, don’t worry. Just relax, play with your dog, and ask for help from an IT friend.

    The Revit user application, which runs in workstations connected to the server, can access the Revit Server folder to open projects. This eliminates the need for anyone to manually navigate to a folder using Windows Explorer, reducing the risk of accidentally deleting or moving files. Once the user connects to the server and opens a project, it creates a local copy in the My Documents folder on the workstation. Then, the user only needs to open that file to continue working until syncing with the server to send changes in the file to the server.

    We all know that working in Revit in a single office isn’t ideal unless you have all the subcontractors working in the same office. The most important thing with the Revit Server is that you need a static IP to create connections between offices to work together. IT guys call it WAN, or wide area network. Only then will Revit power the projects to be truly competitive and efficient.

    Thanks for reading, and I hope this helps to find a new angle into your Revit workflows.

    by

  • Supply Chain Management in Construction

    Alluvial Diagram + hybrid Modifications / “Sankey Diagram”

    During my supply chain management classes, I created a fictional supply chain system for a hypothetical company called “Max Profit Industries” to highlight its complexity and summarize key information for easier focus. Similar to most modern infographics, this map is detailed yet presents a simplified visualization. Thickness indicates the importance of certain branches, while colors designate the roles and tasks of subcontractors. Columns represent the subcontractor tiers, and various symbols are used to depict information flow and item delivery.

    PS: The lecturer referred to the map as a Sankey Diagram, but since I was uncertain about its exact definition, I opted to call it an Alluvial Diagram, as it was labeled in the application I used. However, after making some modifications and enhancements, the map evolved into a hybrid form.

    by

  • MS Project : CMP Timeline

    For my Project Management Theory course, I’ve created a timeline for our assignment, which focuses on a mixed-use zone project featuring hotels, residential apartments, cafes, and landscape design. This was my inaugural experience with Ms Project, and I found the program to be surprisingly intuitive, enabling me to undertake this task. In my opinion, this timeline provides a far more effective summary of the project than the traditional scheduling approach, which required six A0 sheets to visually represent my project.

    by

  • Private Villa | Oculus Rift Walkthrough + BIM Model

    Videogame walkthrough for a tiny country side project, showcasing a villa design. The game can be accessed through the link provided below, which was also mentioned in my previous post. This standalone game represents the villa project and aims to give the client a clear picture of what the final outcome will look like. Initially, I envisioned using Oculus Rift to achieve a highly immersive visual communication method. However, due to the client being in Turkiye, I opted for developing a standalone game that can be played on their computers. I believe this approach to architectural visualization will become increasingly prevalent in the future.

    The design was tailored to the client’s specifications. The project’s primary goal was to deliver a cost-effective, lean structure that provides a simple shelter with three bedrooms on a farm. Therefore, I aimed to maintain minimalism throughout the design, although features like sky windows, sloped roofs, and large fixed windows were considered luxurious additions to the project.

    The project has potential for various efficiency enhancements, including trombe walls, solar chimneys, and solar panels, all dependent on the client’s budget. Consequently, these features were made optional. Additionally, conducting an energy analysis through Revit could offer insights for optimizing the design to meet ASHRAE standards, reduce carbon footprint, and lower energy needs. This would be a voluntary contribution towards improving the shelter design.

    Also i did a unity game with it’s model to show him the structure. So he will be playing the game of his villa in a few hours. Check the game from here

    So what you need to do is to download the folder named Afsin Villa, then double click then use wasd buttons to navigate. That’s that simple. It seems that it is way much easier to show the client the structure in this way is not it?

    by

  • Oculus Rift / Virtual Reality Tech Demo + Warehouse

    As an enthusiastic virtual reality fan (while being an architect) , i developed some skills from Revit, Rhinoceros modelling programs to Unity Game Engine software to create a virtual reality with gravity, wind, sound, lightning etc.

    What i achieved is that a tech demo, which you can walk inside with the help of Oculus Rift Dk2 hardware, for specific structures modeled in architectural design software. So with this pipeline, professional projects like a residential villa or a hospital project, can actually be simulated and walked inside for various purposes.

    These can be a show for the client to further double check what they are gonna get at the end of the project or can be a design tool to be used by the design team to further research and develop the design before proceeding. Therefore team can actually enter inside the structure and they can actually see everything from first person view.

    This can be generated by Revit or 3ds Max but the problem is that they can give false dept of view, manipulated vision can occur. This type of an experience is more like having a real experience rather than looking to a monitor which has actually two dimension. So that i believe that in near future it will be more likely for architects to use such tools much more efficiently.

    After the design of the game in Unity, it can be exported to many platforms such as Ios / Android / Web / Oculus Rift etc. I published the fourth version of the tech demo that i have done here in Oculus Share Web Site, so on 26th of March it just got published as in their website. From this link you can reach the game and download it free to have a look.

    Also there is a donate button on the right side, you’re welcomed to support me by buying me a cup of coffee.

    by
